PITTSBURGH — The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date .
Traffic from Pittsburgh’s eastern suburbs had grown enough by the early 1920s that city planners began trying to find a faster route downtown . The Citizens Committee on the City Plan of Pittsburgh envisioned upgrading Second Avenue into a four- to six-lane boulevard that would extend all the way to Swissvale. In 1924, residents of Pittsburgh’s East End formed the Boulevard of the Allies Extension Association to promote the plan, and the Allegheny County Department of Public Works began preliminary studies .
By 1934, routes were proposed and being lobbied for, including one that centered on a new tunnel under Schenley Park. The Penn-Lincoln Highway Association was created and eventually settled on promoting a route nearly identical to today’s Parkway East, following a harrowing urban trek in 1937 to demonstrate its necessity to state officials.
The U.S. Bureau of Public Roads approved plans for the new highway on Sept. 16, 1938. The routes included plans for the Squirrel Hill and Fort Pitt Tunnels, but sufficient funding was not secured until 1941 when the Federal Public Roads Administration agreed to match state funds.
Construction on the Squirrel Hill Tunnel started in 1946. The tunnel and its interchange were the first tunnels designed by engineer Michael Baker, Jr. , who also later designed the Fort Pitt Tunnel. The firm that he started now employs thousands of engineers in nearly 100 offices nationwide from its corporate headquarters in the BNY Mellon Center on Grant Street.
Drilling started on Sept. 7, 1948 . Excavation progressed from both ends, advancing 12 to 24 feet per day, with crews from both sides meeting in the middle on Sept. 15, 1949. About 400,000 cubic feet of earth was moved, much of it graded on the eastern side of the tunnel to form the approach to the Commercial Street Bridge over Nine Mile Run .
Squirrel Hill Tunnel At a total cost of $18 million, the Squirrel Hill Tunnel was the most costly single project built by the State Highways Department and completed the last link in the first eight-mile section of the Penn-Lincoln Parkway. (Detre Library & Archives, Sen. John Heinz History Center) Squirrel Hill Tunnel Construction of the Squirrel Hill Tunnel. Picture taken in 1949. (Archives & Special Collections, University of Pittsburgh Library System) Squirrel Hill Tunnel Frazier Street at Junction Hollow, where the Parkway East's approach to the Squirrel Hill Tunnel would be build. Junction Hollow divides Schenley Park from the rest of Pittsburgh’s Oakland neighborhood by a 150-foot-deep gorge. The early residents of that community knew the hollow as Four-Mile Run. Four-Mile Run’s name was derived from its distance to the Point in downtown Pittsburgh. The current name refers to the tracks of the Pittsburgh Junction Railroad that were laid here in 1884-86. This area has also been referred to as the Saline Valley. The wood frame church near the center of the photograph is Saint Joachim’s Roman Catholic Church. The church in the far background is Saint John Chrysostom Byzantine Catholic Church where famed pop artist Andy Warhol was baptized. (Detre Library & Archives, Sen. John Heinz History Center) Squirrel Hill Tunnel Construction of the Squirrel Hill Tunnel. Picture taken in 1949. (Archives & Special Collections, University of Pittsburgh Library System) Squirrel Hill Tunnel Looking east toward Swissvale and Edgewood, the Union Switch and Signal Building can be seen in the center background. This was the future route of the Parkway East. The first contract for preparing the plans for the new Penn-Lincoln Parkway was given to Michael Baker, Jr. of Pittsburgh in November 1943. The estimated cost of the project at the time was $20 million. The figure was underestimated because the Squirrel Hill Tunnel itself cost $18 million to build, the most expensive project ever undertaken by the Pennsylvania Department of Highways at the time. The Squirrel Hill Tunnel was dedicated on June 5, 1953. (Detre Library & Archives, Sen. John Heinz History Center) Squirrel Hill Tunnel Eastern portal of the Squirrel Hill Tunnel under construction. The Department of Highways on August 5, 1948, announced that construction of the Squirrel Hill Tunnel would begin on September 1 of that same year. At a total cost of $18 million, it was the most costly single project built by the State Highways Department and completed the last link in the first eight-mile section of the Penn-Lincoln Parkway. The total length of the tunnel is 4,225 feet with a posted vertical clearance of 13 feet, 6 inches. The width of the tunnel is approximately 28 feet. The Squirrel Hill Tunnel was dedicated on June 5, 1953. (Detre Library & Archives, Sen. John Heinz History Center) Squirrel Hill Tunnel Initial phase of the construction of the Commercial Street Bridge along the Penn-Lincoln Parkway, as viewed from the near the site of the Squirrel Hill Tunnel's eastern portals. The bridge has 3 arches with a length of 170 feet each and 12 approach spans at a length of 28 feet each. The total length of the bridge, including the longest elevated ramp, is 846 feet. The height of the deck has a clearance of 85 feet at the arch and a width of 68 feet. The bridge, a pair of twins each featuring two-ribbed arches, includes nearly 2.5 million pounds of steel reinforcing bars and 15,000 cubic yards of concrete. Material excavated during the construction of the Squirrel Hill Tunnel fills a part of Nine Mile Run Valley to a depth of 100 feet on a 1,000 foot long approach to the Commercial Street Bridge. Construction began in April 1948 and was completed in April 1951 at a cost of $1.78 million by Dinardo, Inc. of Pittsburgh. (Detre Library & Archives, Sen. John Heinz History Center) Squirrel Hill Tunnel Construction of the Commercial Street Bridge along the Penn-Lincoln Parkway (Interstate 376), or known locally as the Parkway East. The bridge has 3 arches with a length of 170 feet each and 12 approach spans at a length of 28 feet each. The total length of the bridge, including the longest elevated ramp, is 846 feet. The height of the deck has a clearance of 85 feet at the arch and a width of 68 feet. The bridge, a pair of twins each featuring two-ribbed arches, includes nearly 2.5 million pounds of steel reinforcing bars and 15,000 cubic yards of concrete. Construction began in April 1948 and was completed in April 1951 at a cost of $1.78 million by Dinardo, Inc. of Pittsburgh. (Detre Library & Archives, Sen. John Heinz History Center) Squirrel Hill Tunnel The Commercial Street Bridge, spanning the Nine Mile Run Valley, under construction along the Penn-Lincoln Parkway (Interstate 376) as seen from near the eastern portals of the Squirrel Hill Tunnel. The total length of the bridge, including the longest elevated ramp, is 846 feet. The height of the deck has a clearance of 85 feet at the arch and a width of 68 feet. The bridge, a pair of twins each featuring two-ribbed arches, includes nearly 2.5 million pounds of steel reinforcing bars and 15,000 cubic yards of concrete. Material excavated during the construction of the Squirrel Hill Tunnel, right foreground, fills a part of Nine Mile Run Valley to a depth of 100 feet on a 1,000-foot long approach to the Commercial Street Bridge. Construction began in April 1948 and was completed in April 1951 at a cost of $1.78 million by Dinardo, Inc. of Pittsburgh. (Detre Library & Archives, Sen. John Heinz History Center) Squirrel Hill Tunnel Taylor Alderdice High School Band in front of the Squirrel Hill Tunnel during the dedication of the Penn-Lincoln Parkway (Interstate 376), or known locally as the Parkway East. The Department of Highways on August 5, 1948, announced that construction of the Squirrel Hill Tunnel would begin on September 1 of that same year. The contract, totaling $13,767,843, was awarded to Perini & Sons, Inc. of Framingham, Massachusetts. This did not include construction of the tunnel lining and highway surface inside the tunnel, nor the ventilating building or pavement of the approaches. At a total cost of $18 million, it was the most costly single project built by the State Highways Department and completed the last link in the first eight mile section of the Penn-Lincoln Parkway. The total length of the tunnel is 4,225 feet with a posted vertical clearance of 13 feet, 6 inches. The width of the tunnel is approximately 28 feet. (Detre Library & Archives, Sen. John Heinz History Center) Squirrel Hill Tunnel Caption on the back of the photograph reads, “An aerial view of the Penn-Lincoln Parkway east. Squirrel Hill Tunnel in the rear was one of the major construction tasks in this section, costing about $18,000,000.” The Squirrel Hill Tunnel was the most expensive project ever undertaken by the Pennsylvania Department of Highways at the time. (Detre Library & Archives, Sen. John Heinz History Center) Squirrel Hill Tunnel The Commercial Street Bridge, spanning the Nine Mile Run Valley, along the Penn-Lincoln Parkway (Interstate 376) with the Squirrel Hill Tunnel to the upper left corner. The bridge has 3 arches with a length of 170 feet each and 12 approach spans at a length of 28 feet each. The total length of the bridge, including the longest elevated ramp, is 846 feet. The height of the deck has a clearance of 85 feet at the arch and a width of 68 feet. Construction began in April 1948 and was completed in April 1951 at a cost of $1.78 million by Dinardo, Inc. of Pittsburgh. Material excavated during the construction of the Squirrel Hill Tunnel (left background) fills a part of Nine Mile Run valley to a depth of 100 feet on a 1,000-foot long approach to the Commercial Street Bridge. (Detre Library & Archives, Sen. John Heinz History Center) Three construction workers were killed during work on the tunnels out of a total of six who died completing that entire section of the Parkway East. The tunnels were the last link in the Parkway East’s first eight-mile section and cost $18 million to complete .
Gov. John S. Fine cut the ribbon to open the first section of the Parkway East on June 5, 1953. Ceremonies were held at the city side portal to the Squirrel Hill Tunnel.
The 4,225-foot-long twin tunnels have reinforced concrete walls that are 27″ thick . The original ceiling of the tunnel was made of suspended reinforced concrete slabs that were 6″ thick and housed a ventilation shaft topped by an arched outer roof that is about 3 feet thick. The flat concrete ceiling panels were removed in the 2012-2015 renovation to improve vertical clearance. That renovation project cost $49.5 million .
There are eight cross-tunnel passageways that can be used in the event of emergencies, with each protected by a fire door, fire extinguishers and hose valves for first responders to use.
Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. Squirrel Hill Tunnel The Squirrel Hill Tunnels opened to traffic for the first time after a ribbon-cutting ceremony on June 5, 1953, marking the completion of PennDOT’s single most expensive road project to that date. The new tunnels had 2,312 light fixtures with 4,624 bulbs and eight ventilation fans (four in each portal building) to keep air moving and avoid the buildup of fumes that had nearly caused a disaster in the Liberty Tunnels .

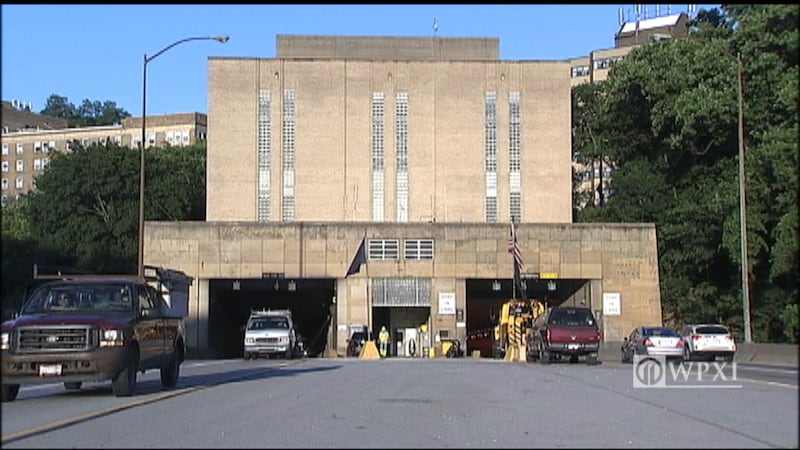

The Tunnel Portal Buildings house maintenance garages and control rooms for the exhaust and ventilation systems. Each portal building is essentially the same, though the West Portal Building has a basement underneath. The exteriors are clad in sandstone and brick veneers, with louvered openings and glass block windows. An overheight truck detection system and traffic signals have been added to each entrance.
Beginning in 2000, a group of Carnegie Mellon University students under the leadership of professor Dan Stancil installed wires in the Squirrel Hill and Fort Pitt tunnels to ensure AM-FM radio and cell reception . PennDOT had received estimates from contractors that surpassed $100,000, but Stancil’s group did it at minimal cost, about $15,000 for Fort Pitt Tunnel .
Being able to enjoy their favorite songs during their tunnel transits has done little to alleviate the common frustrations of Pittsburgh drivers, however. Traffic still notoriously slows due to the perception change of approaching and entering the tunnels, an effect known as “optical flow ,” where visual cues trick drivers into assuming they are driving faster than they actually are.
PennDOT engineers have tried to lessen this effect by installing brighter lights at the tunnel entrances to hasten eye adjustments, but the tunnel’s traffic flow is also hampered by ramps Jalopnik rated as the 2nd worst in the U.S. and U.K. , where entering drivers are forced to stop and accelerate quickly as exiting drivers dodge them with a crossing merge point right at the threshold of the Eastbound tunnel.
